AACE International PSP - Planning & Scheduling Professional (PSP) Exam
What method would be the best way to determine the most likely as-built critical path of a project that is underway, and the schedule of which has been partially progressed?
Total float is defined as the amount of time an activity can be delayed without impacting

Which activity is drawn in the incorrect position?

Why does activity 11001 not show successor activities?

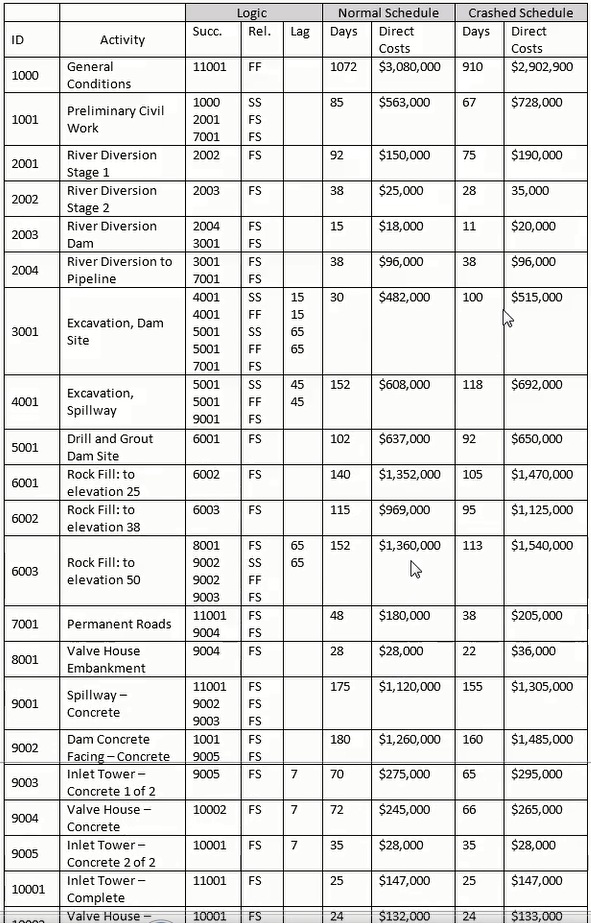

Using the normal schedule, theoretically construct a hammock for activities 6001-6003. What is the duration of the hammock?
The Baseline Plan does NOT reflect which of the following:
The BEST reason to use multiple calendars is to:
Project schedules help control all of the following EXCEPT for_____________________.

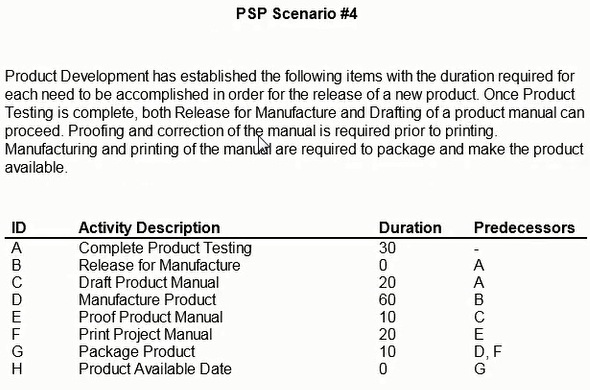

Value engineering is:
If a cost estimate assumes that 240 hours will be expended on a given activity, and the projected crew size expected to perform that activity is 5 personnel working and 8-hour workday, what is the calculated duration for the activity?
