AACE International PSP - Planning & Scheduling Professional (PSP) Exam
Which of the following is not an internal stakeholder?

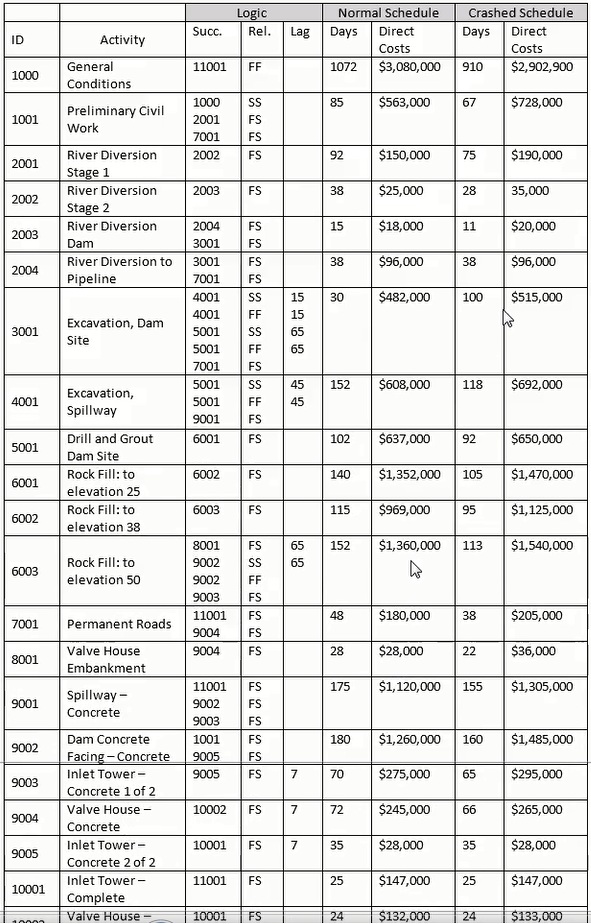

Determine the correct formula and date for the late finish for Activity 2002.

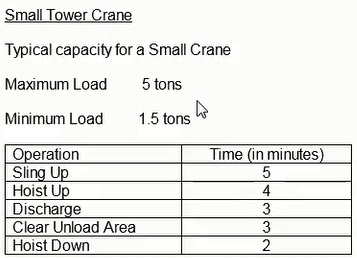

Each column must be poured in one day. Each column requires 2,000 cubic feet of concrete. The lift bucket has a capacity of 40 cubic feet. How many lifts will be required per column pour?

What is the result of a forward pass calculation?
When reconstructing a CPM schedule electronically from a hardcopy, which of the following is NOT required to determine the critical path?
What project cost elements would NOT normally be reflected in the Activity 1000?
Which of the following is NOT true?
Schedules are periodically updated to reflect progress. What step should NOT occur before the update is considered complete?
What is accurate about Activity 7001 in the precedence diagram?
Which of the following documents is most likely to be of the LEAST value to a planner/scheduler when planning a contractor's baseline critical path schedule for the construction of a large high-clearance bridge located very near an airport? The contractor has been awarded the contract.
