AACE International PSP - Planning & Scheduling Professional (PSP) Exam
If a contractor has robust planning and scheduling processes, should those company processes supersede client contract specifications?
When using a detailed estimate as the basis for work package/activity durations, which element does NOT need to be identified before the activity durations can be calculated?

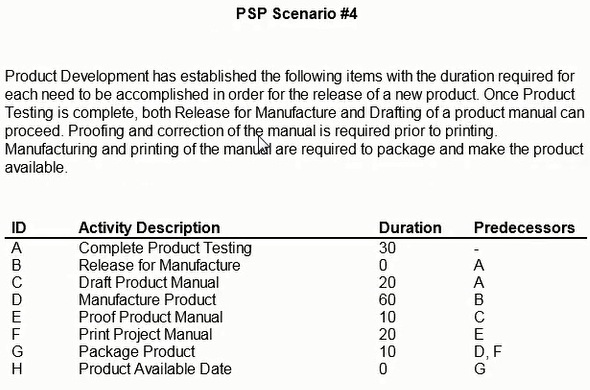

If drafting of the product manual overruns its planned duration by 5 days, how many days may the manufacturing be delayed without affecting release of the product?
What is a key first step in developing a critical path method schedule?
What owner action could have mitigated the late completion of the project?
Which of the following procedures is generally recognized as acceptable when updating a schedule?

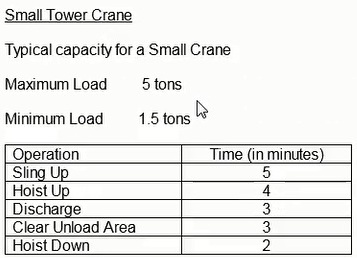

What is the cycle time?

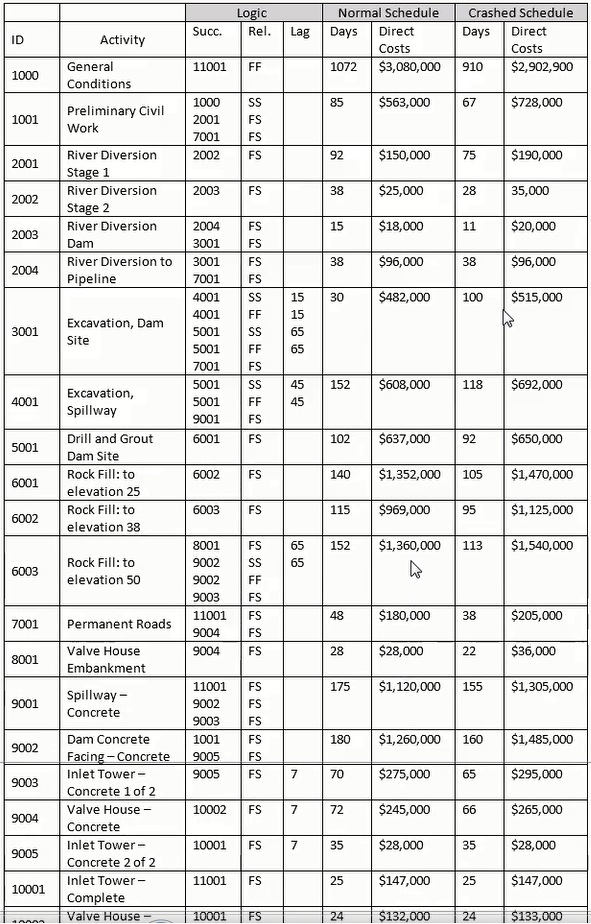

Using the normal schedule, given Activity 3001 and the relationship with Activity 4001. what is indicated?
Which of the following is NOT a tool or technique used to perform scope planning?

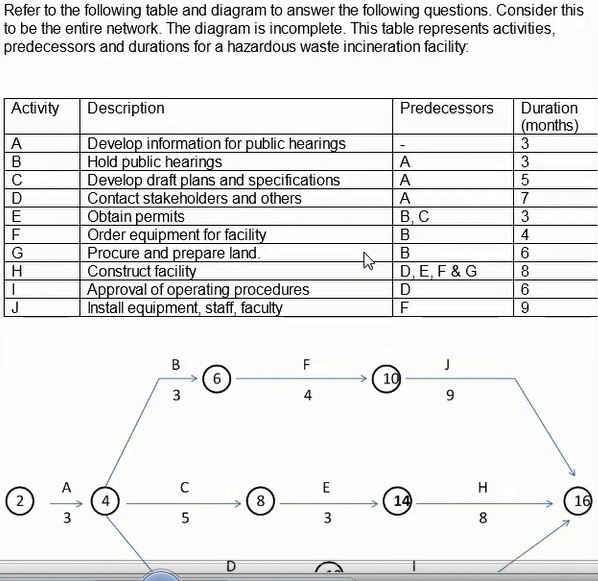

Identify the minimum project duration.
